Introduction

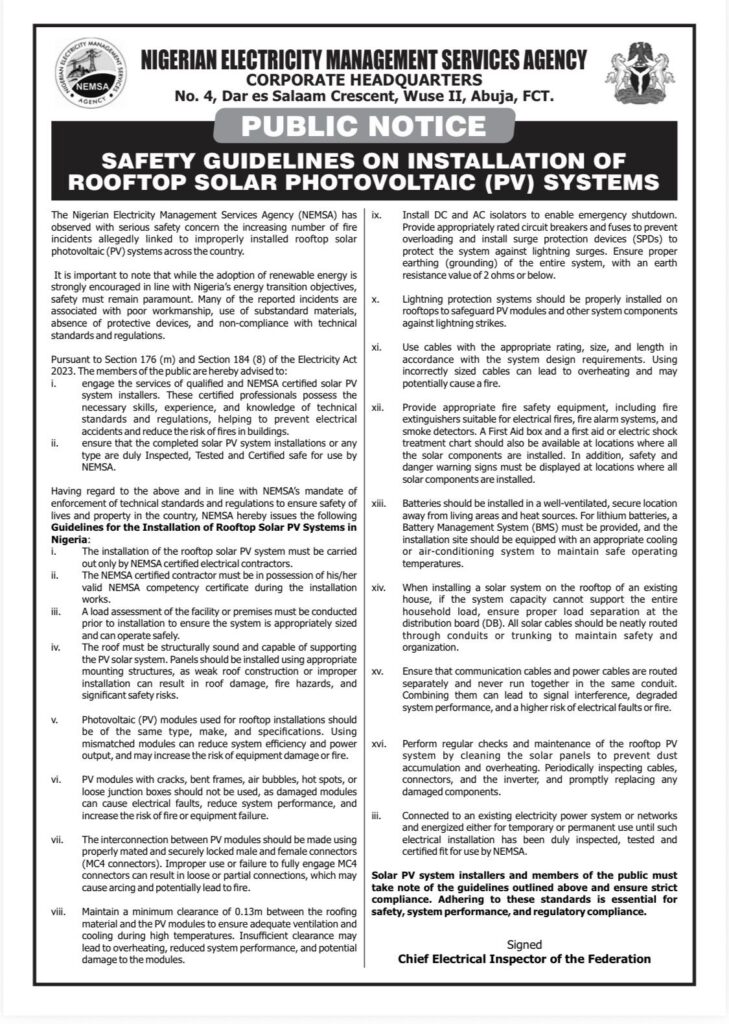

The Nigerian Electricity Management Services Agency (NEMSA) has issued a public notice establishing comprehensive safety guidelines for the installation of rooftop solar photovoltaic (PV) systems across Nigeria. This regulatory intervention follows a concerning increase in fire incidents linked to improperly installed solar installations and represents a significant shift in the compliance landscape for renewable energy infrastructure.
Published under the authority of Section 176(m) and Section 184(8) of the Electricity Act 2023, the notice imposes mandatory certification, inspection, and technical compliance requirements on all solar PV system installers and users. Non-compliance carries regulatory penalties, potential civil liability, and insurance coverage implications.
This article examines the key provisions of the guidelines, their legal and commercial implications, and the practical steps that developers, contractors, and property owners must take to ensure compliance.
Background: Why NEMSA Issued These Guidelines
Nigeria’s renewable energy sector has experienced rapid growth as businesses and households seek alternative power solutions in response to grid instability and rising energy costs. However, this growth has been accompanied by an increase in substandard installations characterised by poor workmanship, use of inferior materials, absence of protective devices, and non-compliance with technical standards and regulations.
NEMSA has observed a disturbing pattern of fire incidents directly attributable to these deficiencies. The consequences extend beyond property damage to include loss of income, business interruption, and erosion of public confidence in solar energy as a safe and viable alternative.
The guidelines, therefore, serve a dual purpose: safeguarding lives and property whilst ensuring that Nigeria’s energy transition is built on a foundation of technical competence and regulatory compliance.
Legal Framework and Enforcement Authority
The Electricity Act 2023 vests NEMSA with broad powers to enforce technical standards and regulations for electrical installations across Nigeria. Specifically:
Section 176(m) empowers NEMSA to engage the services of qualified and certified solar PV system installers to prevent electrical accidents and reduce fire risks in buildings.
Section 184(8) mandates that all completed solar PV installations must be duly inspected, tested, and certified safe for use by NEMSA before operation.
These provisions grant NEMSA not only the authority to issue guidelines but also the enforcement mechanism to ensure compliance through inspection regimes, certification requirements, and sanctions for non-compliance.

Key Compliance Requirements
The NEMSA guidelines establish detailed technical and procedural requirements for rooftop solar PV installations. The most critical obligations are outlined below.
1. Mandatory Use of NEMSA-Certified Installers
All rooftop solar PV system installations must be carried out exclusively by NEMSA-certified contractors. This requirement is absolute and applies regardless of system size, capacity, or intended use.
From the above, one can infer that engaging an uncertified installer, even for small-scale residential installations, constitutes a regulatory violation. Property owners and developers who contract with uncertified installers may face enforcement action and bear liability for resulting accidents or incidents.
2. Compulsory Certification of Installations
Every completed solar PV installation must undergo inspection, testing, and certification by NEMSA before the system can be lawfully energised or connected to any electricity network.
The certification process verifies that:
- The installation complies with applicable technical standards
- All safety devices and protective equipment are properly installed
- Structural integrity requirements have been met
- The system poses no fire, electrical, or structural hazard
It therefore implies that operating an uncertified solar PV system is illegal and exposes the owner to regulatory penalties, voided insurance coverage, and direct liability in the event of an incident.
3. Structural Integrity Assessment
Before installation, a load assessment of the facility or premises must be conducted to ensure that the roof structure can safely support the solar system, mounting structures, and associated equipment.
Weak or improperly designed roof structures can result in roof collapse, fire hazards, and other safety risks. The guidelines make clear that developers and property owners bear responsibility for ensuring structural adequacy.
This requirement introduces a duty of care that extends beyond electrical compliance to encompass structural engineering considerations. Failure to conduct proper assessments creates liability exposure for both installers and property owners.
4. Technical Standards for Equipment and Installation
The guidelines prescribe detailed technical requirements, including but not limited to:
- Photovoltaic modules: Must be of uniform type, make, and specifications. Damaged, mismatched, or substandard modules are prohibited.
- DC and AC isolators: Must be appropriately rated to enable emergency shutdown and prevent system overload.
- Circuit protection: Installation of properly rated circuit breakers and fuses to prevent overloading and protect against surge damage and lightning strikes.
- Earthing (grounding): The entire system must be properly earthed with earth resistance values of 2 ohms or below to prevent electrical faults.
- Lightning protection systems: Must be installed on rooftops to safeguard PV modules and system components against lightning strikes.
- Cable specifications: Cables must be appropriately rated for size and length, with solar cables routed through metal conduits or trunking to maintain safety and organisation.
- Fire safety equipment: Including fire extinguishers suitable for electrical fires, fire alarm systems, and smoke detectors. Emergency contact information and treatment charts must be displayed at installation sites.
- Battery storage: Batteries must be installed in well-ventilated, secure locations away from living areas and heat sources. Lithium batteries require a Battery Management System (BMS) with appropriate cooling or air conditioning.
- Clearance requirements: Minimum clearance of 0.13 metres between roofing material and PV modules to ensure adequate ventilation and cooling.
- Cable routing: Communication cables and power cables must be routed separately to prevent signal interference and reduce fire risk.
These technical standards are not optional guidelines. They represent mandatory compliance thresholds, and deviations expose installers and owners to liability for accidents, system failures, and regulatory enforcement.
5. Regular Maintenance and Inspection
The guidelines require regular maintenance of rooftop PV systems, including cleaning of solar panels, periodic inspection of cables and connectors, inverter maintenance, and prompt replacement of damaged components.
Systems connected to existing electricity networks or operating temporarily without permits must be duly inspected, tested, and certified by NEMSA.
It is now obvious that compliance is not a one-time obligation. Property owners and facility managers must implement ongoing maintenance regimes to preserve system safety and regulatory compliance.
Possible Legal and Commercial Implications
For Solar Developers and EPC Contractors
The guidelines fundamentally alter the risk profile for solar development and installation businesses. Key implications include:
Regulatory compliance as a competitive advantage: Certified installers now operate in a regulated market where certification is a prerequisite for lawful business operation. This creates a natural market advantage for compliant operators whilst exposing non-compliant competitors to enforcement action.
Liability exposure for non-compliance: Installing systems without certification or failing to meet technical standards exposes contractors to civil liability for property damage, personal injury, and economic losses arising from system failures or fires. Insurance coverage is likely to be voided where installations do not comply with regulatory requirements.
Contractual risk allocation: EPC contracts must now explicitly address NEMSA certification obligations, allocate responsibility for compliance costs, and define liability for delays or penalties arising from inspection failures.
Reputational risk: In a sector built on trust and technical credibility, regulatory sanctions or association with non-compliant installations can severely damage market reputation and client confidence.
For Corporate Clients and Property Owners
Property owners procuring solar installations face significant compliance obligations and liability risks:
Due diligence requirements: Clients must verify that contractors hold valid NEMSA certification before awarding contracts. Engaging uncertified installers exposes clients to direct regulatory liability and potential civil claims from third parties affected by system failures.
Insurance implications: Insurance policies covering property damage or fire typically exclude losses arising from illegal or non-compliant installations. An uncertified solar installation may void coverage for the entire property, not merely the solar system itself.
Structural liability: Property owners bear ultimate responsibility for ensuring that their buildings can safely support solar installations. This may require engaging structural engineers to conduct independent assessments, particularly for older buildings or those not originally designed to accommodate rooftop equipment.
Ongoing compliance obligations: Certification is not a one-time event. Property owners must ensure that systems remain compliant through regular maintenance, periodic re-inspection, and prompt repairs or upgrades as standards evolve.
For Project Financiers and Investors
Financial institutions and investors funding solar projects must integrate NEMSA compliance into due diligence and risk assessment frameworks:
Compliance as a condition precedent: Loan agreements and investment contracts should make NEMSA certification a condition precedent to disbursement, ensuring that financed projects meet regulatory standards from inception.
Security interest considerations: Lenders taking security interests over solar installations must verify compliance status, as non-compliant systems may be subject to removal orders or may lack insurable value.
Environmental, Social, and Governance (ESG) considerations: Regulatory compliance, particularly concerning safety standards, aligns with ESG investment criteria. Non-compliant projects present reputational risks for financiers committed to responsible investment practices.
Practical Steps for Compliance
For Developers and Contractors
- Obtain NEMSA certification if not already certified. Verify that all installation personnel hold requisite technical qualifications.
- Review existing contracts to incorporate NEMSA compliance obligations, certification timelines, and liability allocation provisions.
- Establish quality assurance protocols to ensure that all installations meet technical standards before submission for NEMSA inspection.
- Engage structural engineers early in project planning to conduct load assessments and verify roof adequacy.
- Procure equipment from reputable suppliers and maintain documentation verifying compliance with technical specifications.
- Implement post-installation maintenance programmes to preserve system compliance and address issues before they escalate into safety hazards.
For Property Owners and Corporate Clients
- Verify contractor certification before awarding contracts. Request evidence of NEMSA certification and proof of previous successful installations.
- Conduct independent structural assessments to verify that roofs can safely support proposed solar installations.
- Review insurance policies to confirm that coverage extends to solar installations and that policy terms require regulatory compliance.
- Budget for compliance costs, including inspection fees, potential remedial works, and ongoing maintenance expenses.
- Document all compliance activities, including certifications, inspection reports, and maintenance records, for audit and enforcement purposes.
- Establish clear contractual terms allocating responsibility for obtaining NEMSA certification and liability for non-compliance between the property owner and contractor.
For Financiers and Investors
- Incorporate NEMSA compliance into due diligence checklists and loan covenants.
- Require certification evidence before disbursing funds for solar project financing.
- Engage independent technical advisors to verify compliance for high-value or complex installations.
- Monitor ongoing compliance through periodic reporting requirements in financing agreements.
Conclusion
NEMSA’s safety guidelines represent a necessary and overdue regulatory intervention in Nigeria’s solar energy sector. Whilst the adoption of renewable energy remains essential to addressing Nigeria’s energy challenges, the foundation of that transition must be built on safety, technical competence, and regulatory compliance.
For developers, contractors, property owners, and financiers, these guidelines are not bureaucratic obstacles. They are frameworks for managing commercial risk, protecting investments, and ensuring that Nigeria’s renewable energy infrastructure is sustainable, safe, and fit for purpose.
The regulatory environment around renewable energy infrastructure is tightening across Africa, and Nigeria’s approach sets an important precedent. Businesses that integrate compliance into their operational strategies will be best positioned to thrive in this evolving landscape.
Our Infrastructure and Energy practice advises clients on regulatory compliance, contract structuring, risk allocation, and dispute resolution for renewable energy and construction projects across Nigeria and West Africa.
If you are developing solar projects, procuring installations, or financing renewable energy infrastructure and require guidance on compliance with NEMSA’s guidelines or related regulatory matters, we invite you to contact us @ info@glimsource.com.
Disclaimer: This article is provided solely for general informational and educational purposes and does not constitute legal advice, legal opinion, or regulatory guidance on any specific matter. Readers are advised to seek independent professional advice tailored to their particular circumstances before acting on any information contained herein. Reliance on this publication does not create a solicitor-client relationship.
